HOSTEL PROJECT FOR STUDENTS OF THE

COLLEGE OF MEDICINE, UNIVERSITY OF IBADAN (CoMUI)

administered by the

IBADAN COLLEGE OF MEDICINE ALUMNI ASSOCIATION (ICOMAA)

Construction Activity Reporting Schedule: 14th Report

Date: 3rd May 2024

Site Construction Activities

BLOCK C (PHILIP OZUAH BLOCK)

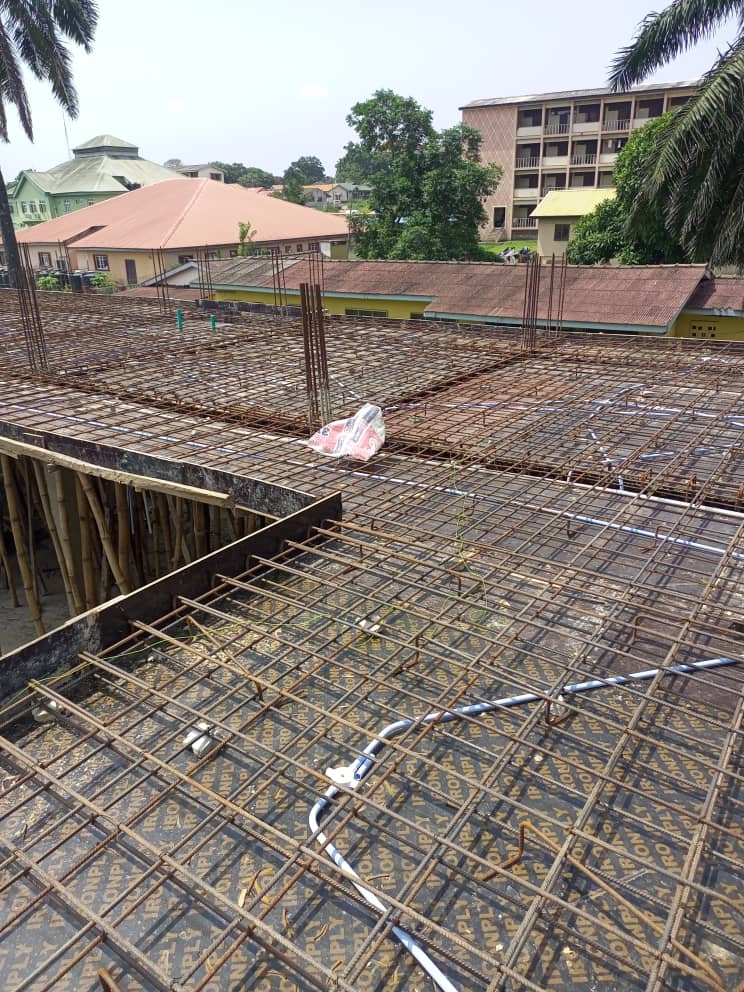

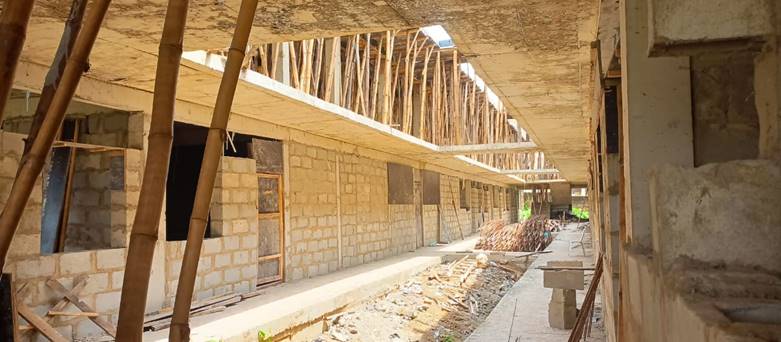

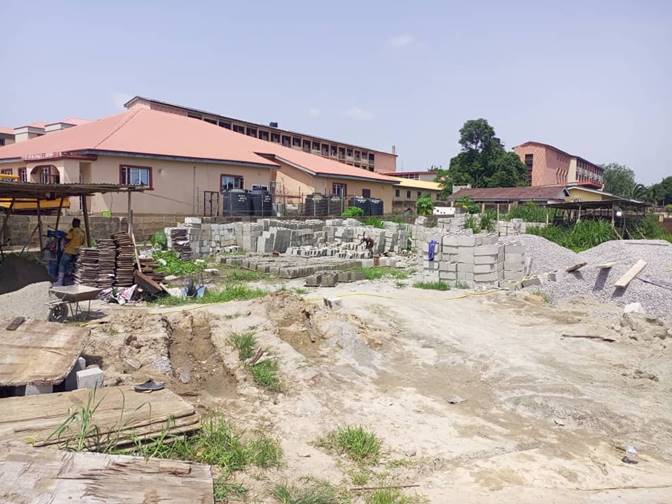

Update: The contractor continues the production of blocks on site. The block laying work for the block walls partitioning the ground floor continues. The placement of steel reinforcements and electrical and mechanical services sleeves into the second-floor slab formwork is nearing completion.

As of 29th of April - 3rd of May, the casting of the second-floor slab was slated for the first week in May.

Challenges: There have been no significant challenges in the construction work of this block.

Pictures of Block C

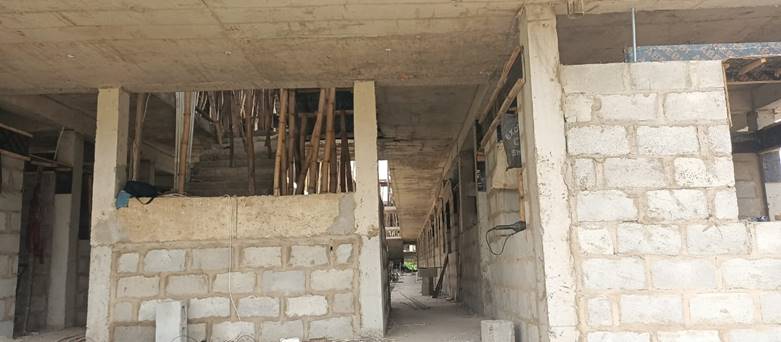

A construction site with steel rods

Description automatically generated

A building under construction with a few buildings

Description automatically generated

A building with a stone wall

Description automatically generated with medium confidence

A building under construction with a concrete walkway

Description automatically generated with medium confidence

Block D (TY Danjuma Block)

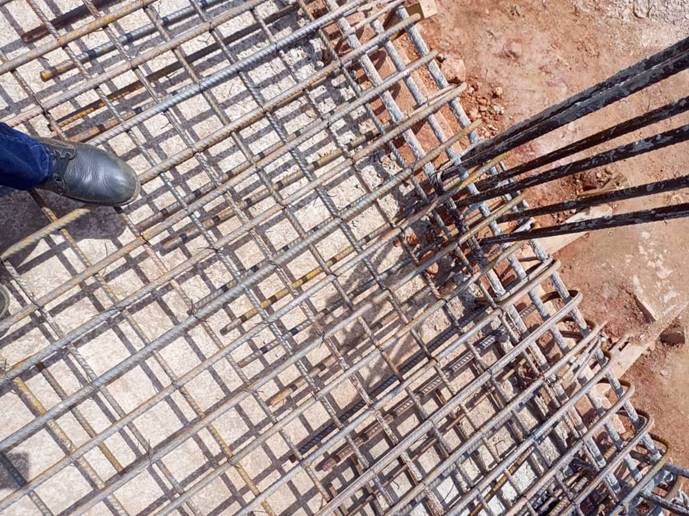

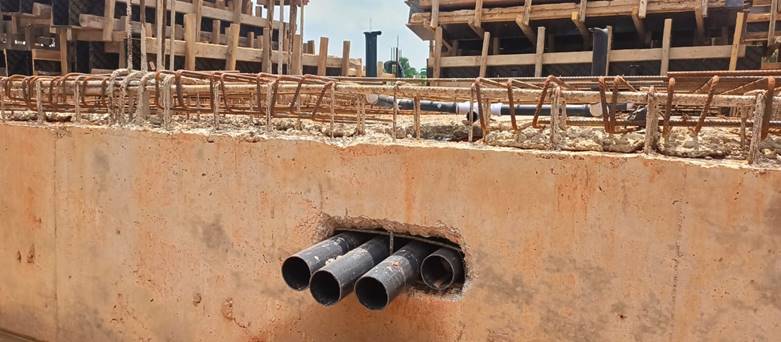

Update: The construction work on this block remains at the substructure level, as the laterite earth filling, compaction, and concrete blinding are completed. The placement of the steel reinforcement and mechanical services sleeves have commenced.

As of the 29th of April � the 3rd of May, the completion of this stage is slated for next week.

Challenges: There have been no significant challenges in the construction work of this block.

Pictures of Work done on site

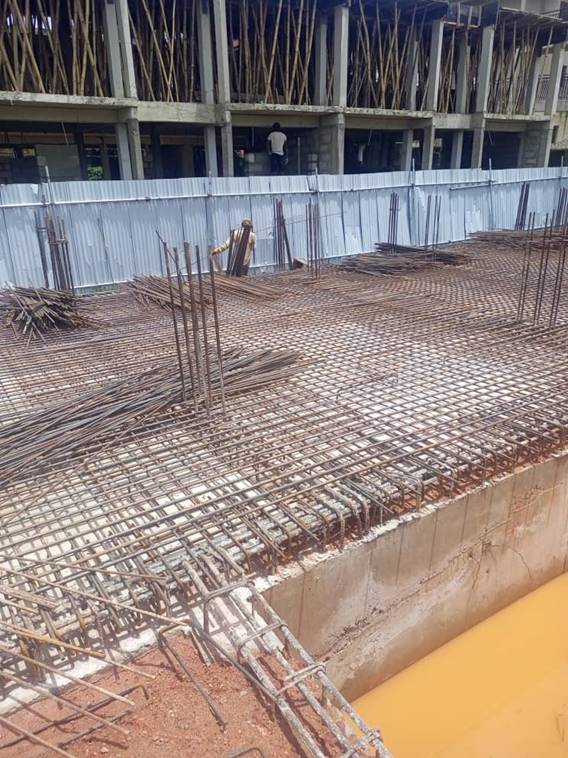

A construction site with a building under construction

Description automatically generated

A pipe in a wall

Description automatically generated with medium confidence

Block F (Alumni Block)

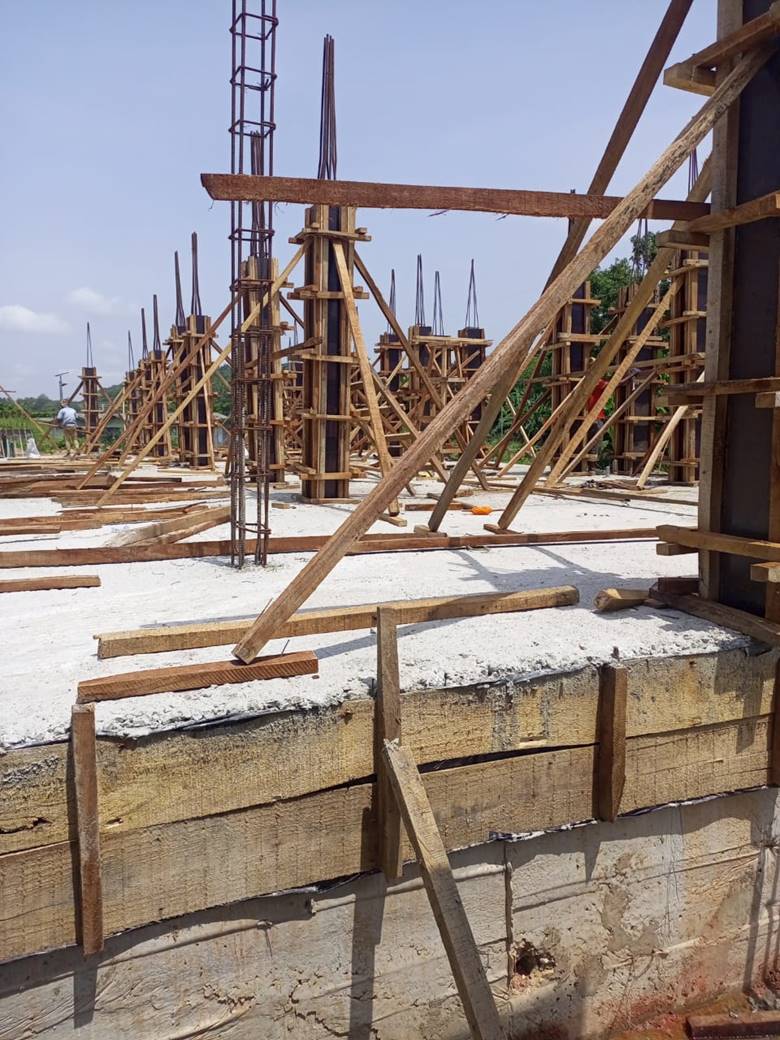

Update: The construction work on this block is at the superstructure level as the casting of the oversite concrete is completed and the raising of the steel reinforcement for the concrete columns to support the first-floor slab commences with the formworks.

As of the 29th of April - 3rd of May, the casting of the oversite concrete slab slated for completion by the close of work on Friday 26th of April, 2024 has been completed.

Challenges: There have been no significant challenges in the construction works of this block.

Pictures of Work done on site

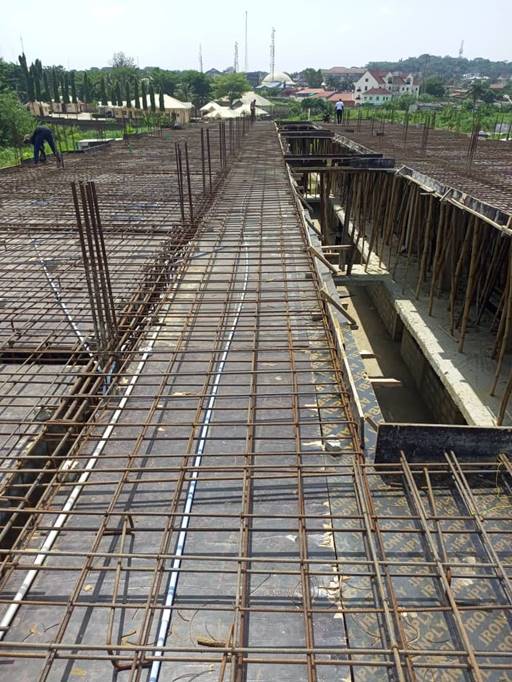

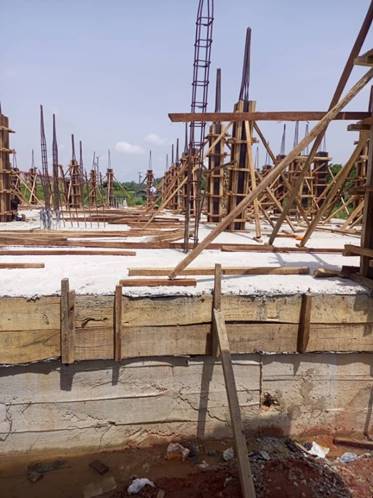

A construction site with wooden beams

Description automatically generated

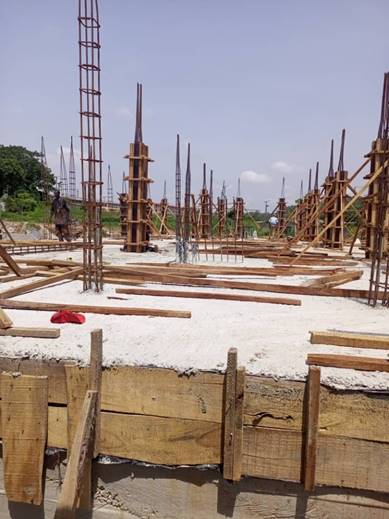

   A construction site with wooden beams

Description automatically generatedA construction site with wooden beams and a crane

Description automatically generated

Signed,

Arc. Dapo Ojo

Project Client Representative

Adapted for publication by

Seun Abimbola

Media Officer

For Inquiries or to make donations

Please contact:

hostelproject@com.ui.edu.ng

provost@com.ui.edu.ng

Send a WhatsApp message to:

Provost: +2348132243158

Deputy Provost: +2348057325888
